The Personal Productivity Dashboard: Unlocking Insights from Your Kanban Data

This article details a systematic framework for this evolution, repositioning the individual from a simple "doer" of tasks to the manager and analyst of their own personal productivity system.

The Personal Productivity Dashboard: Unlocking Insights from Your Kanban Data
The Personal Productivity Dashboard: Unlocking Insights from Your Kanban Data

In the pursuit of personal and professional effectiveness, the predominant paradigm has long been one of task management. Digital and analog to-do lists, calendars, and planners serve as inventories of obligations, helping individuals track what must be done. While valuable, this approach treats productivity as a series of discrete, disconnected items to be checked off. It manages the what but often fails to illuminate the how—the underlying process through which work is actually accomplished. A fundamental evolution in personal productivity is underway, shifting the focus from mere task management to a more sophisticated practice of workflow analysis. This report details a systematic framework for this evolution, repositioning the individual from a simple "doer" of tasks to the manager and analyst of their own personal productivity system.

The central thesis of this new approach is that your work, whether professional projects or personal goals, generates a continuous stream of data. Every task initiated, every stage it passes through, and every completion is a measurable event. By capturing this data, one can move beyond the "quantified self" of tracking habits or fitness and apply the same analytical rigor to the mechanics of knowledge work. This report will demonstrate how to build and interpret a personal productivity dashboard, a system that transforms subjective feelings of being "busy" or "productive" into objective, actionable intelligence.

The foundation of this system is the Kanban method. Originally developed for manufacturing, Kanban has been widely adopted in software development and other forms of knowledge work precisely because of its power to make invisible processes visible. A Kanban board is far more than a visual organizer; it is a data generation engine. Each movement of a card across the board is a timestamped event that feeds the analytical dashboard, providing the raw material for deep insights into personal work patterns. This transition from a prescriptive approach to productivity—one that imposes a set of universal rules or habits—to a diagnostic and evolutionary one is profound. Traditional productivity systems often fail because they are one-size-fits-all solutions applied to unique and dynamic workflows. The Kanban method, in contrast, begins by simply reflecting the current process. One of its core change management principles is to "Start with what you do now". It does not initially demand a change in behavior; it demands observation. The data generated is therefore a personalized diagnostic of an individual's actual work habits, bottlenecks, and capacities. Any subsequent improvements are not based on generic best practices but are tailored, evidence-based interventions. This report will guide the reader on a journey from the basic mechanics of setting up a data-generating Kanban system to mastering advanced analytical charts and, finally, to applying these insights to forge a more effective, predictable, and sustainable personal workflow.

The Anatomy of Your Personal Kanban System: Generating the Raw Data

To build a meaningful productivity dashboard, one must first construct the system that generates the necessary data. A personal Kanban system is this data generator, and its architecture directly determines the quality and granularity of the insights that can be derived. Setting up this system involves defining its core components with the explicit goal of capturing the flow of work.

The Kanban Board: The Visual Data Layer

The Kanban board is the physical or digital canvas where work becomes visible. Its primary function in this context is to transform intangible knowledge work—ideas, projects, tasks—into tangible objects (cards) that can be observed as they move through a process. This visualization is the first step toward measurement. For personal use, this could be a physical whiteboard with sticky notes or, more powerfully, a digital application that automatically logs timestamps and other metadata.

Workflow Stages (Columns): The Data Model

The vertical columns on a Kanban board represent the distinct stages of a workflow. For a personal system, a simple and effective starting point is the three-column layout: "To Do," "Doing," and "Done". "To Do" represents a backlog of committed work, "Doing" contains tasks actively being worked on, and "Done" is the archive of completed items.

However, the design of these columns is, in effect, the design of the data collection model. The metrics that form the basis of the productivity dashboard, such as Cycle Time, are calculated based on the timestamps of a card entering and exiting specific columns. If the workflow stages are too generic, the resulting data will obscure critical details. For example, a single "Doing" column for a writing project might hide the fact that a task spends 90% of its time "Waiting for Feedback" and only 10% in "Active Writing." This distinction is lost, and a potential bottleneck remains invisible.

Therefore, as the user gains clarity on their process, the columns should evolve to reflect the actual states of work. A writer's board might evolve to "Ideas," "Drafting," "Editing," "Awaiting Feedback," and "Published." Each of these columns represents a specific state, and the time a card spends in each is a crucial data point for later analysis. This granular workflow design is the most critical step in building a dashboard that can provide actionable, rather than superficial, insights.

Work Items (Cards): The Units of Measurement

Each card on the Kanban board represents a single, discrete unit of work. For the data to be meaningful, tasks should be "right-sized." A card labeled "Launch New Website" is too large and will sit in the "Doing" column for weeks, distorting all flow metrics. This project should be broken down into smaller, more uniform tasks, such as "Design Homepage Mockup," "Write About Page Copy," or "Configure Hosting". This practice of decomposing large initiatives into smaller, manageable chunks promotes a smoother, more consistent flow of work, which in turn generates more reliable and predictable data.

Digital Kanban cards offer a significant advantage by acting as containers for rich metadata. Beyond the task title, a digital card automatically captures timestamps for every movement between columns and can be augmented with notes, checklists, attachments, due dates, and priority labels. This collection of data for each work item provides a detailed history that is essential for analysis.

The Flow: The Data-Generating Process

The fundamental principle of Kanban is the "pull system," where work is pulled from a preceding stage only when there is capacity in the current stage. In practice, this means moving cards from left to right across the board as work progresses. An item is pulled from "To Do" into "Doing" when capacity becomes available. Once completed, it moves to "Done," freeing up capacity to pull the next item. This sequential movement of cards through the defined workflow stages is the process that generates the series of timestamped events necessary for the analytical dashboard. It is the engine that drives the entire data collection effort.

Core Productivity Indicators: Translating Actions into Metrics

Once the Kanban system is operational, every card movement generates raw data. To make sense of this data, it must be aggregated into a set of core performance indicators. In Kanban, these are known as flow metrics. They provide a quantitative lens through which to view the health, speed, and predictability of a personal workflow. There are four primary metrics that form the foundation of any productivity dashboard.

Lead Time: The Customer Perspective

Lead Time measures the total duration from the moment a task is first requested or added to the system until it is marked as complete. For a personal Kanban board, the "request" can be interpreted as the moment a task is added to the "To Do" column or an "Ideas" backlog. It answers the question: "From the moment I decided this needed to be done, how long did it take to finish?".

Lead Time represents the external perspective on performance. It is the total time a stakeholder—or, in a personal context, your future self—has to wait for a piece of value to be delivered. A long lead time might indicate an efficient work process but a long delay before work begins. This metric is crucial for setting realistic expectations and understanding the overall responsiveness of the system.

Cycle Time: The Internal Process Perspective

Cycle Time is a subset of Lead Time. It measures the duration from when active work begins on a task to when that work is completed. Typically, the clock for Cycle Time starts when a card is pulled from "To Do" into the first "Doing" or "In Progress" column. It answers the question: "Once I started actively working on this, how long did it take to complete?"

Cycle Time is the key indicator of the internal efficiency of the workflow. It isolates the active work phase, providing a clear measure of how quickly tasks move through the process once they are engaged. Analyzing Cycle Time helps identify inefficiencies within the active stages of work, such as rework, interruptions, or skill gaps.

Work In Progress (WIP): The Lever for Flow

Work In Progress (WIP) is simply the number of tasks in the "In Progress" stages of the board at any given moment. Unlike the other metrics, WIP is not a measure of output but rather a critical constraint used to manage the system. A core tenet of Kanban is that multitasking and frequent context switching are profoundly inefficient, killing productivity by adding significant cognitive overhead each time focus is shifted.

By limiting the amount of WIP, an individual forces themselves to focus on completing existing tasks before starting new ones. This practice, known as "Stop starting, start finishing," is fundamental to creating a smooth and predictable flow of work. WIP is not a result to be maximized; it is a limit to be set and respected in order to optimize the other metrics.

Throughput: The Measure of Output

Throughput, also known as delivery rate, is the number of work items completed within a specific time period, such as a day, week, or month. It directly answers the question: "How much work am I actually finishing?" Throughput is the ultimate measure of a system's productive capacity and output. It only counts items that have reached the "Done" state; work that is still in progress does not count. Tracking throughput over time reveals trends in productivity and provides the foundational data for reliable forecasting.

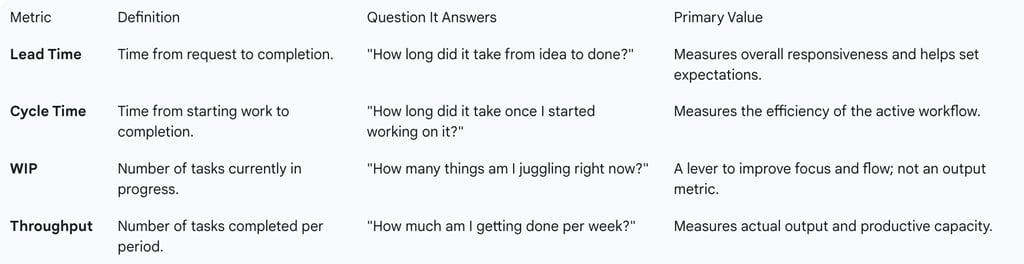

These four metrics are distinct but interconnected. The table below provides a summary to clarify their unique roles.

table below provides a summary to clarify their unique roles
table below provides a summary to clarify their unique roles

A crucial relationship exists between Lead Time and Cycle Time that often reveals the greatest opportunity for productivity improvement. The total Lead Time for any task can be broken down into two components: the time spent actively being worked on (Cycle Time) and the time spent waiting in queues between active stages (Wait Time). The formula is simple:

LeadTime=WaitTime+CycleTime.

Many individuals seeking to improve productivity focus on reducing Cycle Time—that is, trying to perform the active work faster. This approach often yields diminishing returns and can lead to burnout. However, an analysis of the data frequently shows that tasks spend a disproportionate amount of time in waiting states, such as sitting in the "To Do" backlog or in a "Ready for Review" queue. This wait time is a form of waste in the Lean methodology. Therefore, analyzing the

gap between Lead Time and Cycle Time directly quantifies this waste. Reducing this gap—by improving prioritization to shorten time in the backlog or by limiting WIP to reduce queues—can dramatically shorten overall delivery times without requiring the individual to work "harder" or "faster." The focus shifts from optimizing the worker to optimizing the workflow.

Visualizing Your Workflow: Building the Dashboard

Raw metrics provide the numbers, but data visualization tools transform those numbers into patterns and trends that are immediately understandable. A personal productivity dashboard is composed of several key charts, each offering a unique perspective on the workflow's health. The three most essential visualizations for a Kanban system are the Cumulative Flow Diagram, the Control Chart, and the Throughput Histogram.

The Cumulative Flow Diagram (CFD): Your Workflow's Health at a Glance

The Cumulative Flow Diagram (CFD) is an area chart that provides a comprehensive, high-level view of the state of a workflow over time. It plots the cumulative number of work items that have entered each stage of the process. The x-axis represents time, while the y-axis represents the cumulative count of tasks. Each workflow stage (e.g., "To Do," "Doing," "Done") is represented by a different colored band stacked on top of the others.

How to Interpret a CFD:

  • Reading the Bands: The top line of any given band indicates the cumulative arrivals into that stage, while the bottom line represents cumulative departures.

  • Measuring Key Metrics: The CFD visualizes the three core flow metrics simultaneously :

    • Work In Progress (WIP): The vertical distance between the top line of the first "In Progress" stage and the bottom line of the last "In Progress" stage represents the total number of items currently being worked on.

    • Approximate Average Cycle Time: The horizontal distance between the top line of the first "In Progress" stage and the top line of the "Done" stage represents the average time it takes for tasks to move through the active workflow.

    • Throughput (or Departure Rate): The slope of the top line of the "Done" band indicates the rate at which work is being completed. A steeper slope means higher throughput.

  • Identifying Workflow Patterns: The shape and relationship of the bands are the most important indicators of workflow health :

    • Parallel Bands: When the bands are roughly parallel, it signifies a stable workflow. The rate of work entering the system is approximately equal to the rate of work leaving it. This is the ideal state.

    • Widening Bands: A widening band for a specific stage is a clear visual indicator of a bottleneck. It means that work is arriving at that stage faster than it is leaving, causing a queue to build up. This is the most critical signal a CFD provides.

    • Narrowing Bands: A narrowing band suggests that work is leaving a stage faster than it is arriving. This could indicate that a previous bottleneck has been resolved or that there is underutilized capacity in that stage.

The Control Chart: Assessing the Predictability of Your Process

The Control Chart is a diagnostic tool that focuses specifically on Cycle Time to assess the stability and predictability of a process. It is a scatter plot where each dot represents a single completed work item. The vertical axis shows the cycle time for that item, and the horizontal axis shows the date it was completed. The chart also includes a horizontal line for the average cycle time and a shaded band representing the standard deviation, which measures the variability of the data.

How to Interpret a Control Chart:

  • Assessing Predictability: The primary purpose of the chart is to visualize the variation in cycle times.

    • Tight Clustering: If the dots are tightly clustered around the average line with a narrow standard deviation band, the process is stable and predictable. One can have high confidence that future tasks will take a similar amount of time to complete.

    • Wide Scatter: If the dots are widely scattered and the standard deviation band is large, the process is unstable and unpredictable. Forecasting future completion times becomes very difficult.

  • Identifying Outliers: Dots that fall far above the average are outliers. These represent tasks that took an unusually long time to complete. These are prime candidates for investigation in a personal retrospective to understand the root cause (e.g., unexpected complexity, external blocker, or a task that was too large).

  • Spotting Trends: A rolling average line (often shown in blue) can reveal trends over time. A consistent downward trend in the rolling average indicates that the process is becoming more efficient (cycle times are decreasing). Conversely, an upward trend signals a systemic problem that is slowing down the workflow.

The Throughput Histogram: Understanding Your Capacity for Work

While the Control Chart focuses on how long tasks take, the Throughput Histogram focuses on how much work gets done. It is a bar chart that displays the frequency distribution of throughput. It answers the question, "On a typical day (or week), how many tasks do I complete?"

How to Interpret a Throughput Histogram:

  • Reading the Axes: The horizontal axis represents the throughput count (e.g., 0 tasks completed, 1 task completed, 2 tasks completed, etc.). The vertical axis represents the frequency—the number of days or weeks that a particular throughput was achieved.

  • Understanding Output Consistency: The shape of the distribution reveals the consistency of the output.

    • Narrow Distribution: A histogram with a tall, narrow peak indicates a highly consistent and predictable process. For example, if the bar for "2 tasks per day" is much taller than all others, it means that completing two tasks is a very common and reliable outcome.

    • Wide Distribution: A wide, flat histogram indicates high variability in output. Some days might have zero throughput, while others have very high throughput. This suggests an inconsistent or "lumpy" workflow.

  • Probabilistic Forecasting: The histogram is a powerful tool for forecasting. By adding percentile lines, one can make probabilistic statements about future capacity. For example, an 85th percentile line at a throughput of "3 tasks" means that on 85% of days, the throughput was 3 tasks or fewer. This provides a data-driven, realistic upper bound for planning, far more reliable than relying on a simple average.

These three charts, when used together, provide a multi-faceted view of personal productivity. The table below serves as a quick reference for selecting the right tool for the right question.

selecting the right tool for the right questio
selecting the right tool for the right questio

It is critical to understand that these visualizations tell a connected story. A problem that appears in one chart will have corresponding symptoms in the others. For instance, if the Cumulative Flow Diagram begins to show a widening band in the "Editing" stage, this identifies a bottleneck. This same problem will manifest on the Control Chart as an increase in the cycle times of completed tasks, causing the dots to trend upwards and scatter more widely; the process is becoming less predictable

because of the bottleneck. Simultaneously, this bottleneck will impact the Throughput Histogram. Because tasks are getting stuck in "Editing," fewer are moving to "Done," causing the overall throughput to decrease. This will shift the histogram's distribution to the left, with more days showing a lower number of completed tasks. By learning to cross-reference the charts, an individual can move from simple observation to a sophisticated, integrated diagnosis of their workflow. The CFD identifies where the problem is, the Control Chart quantifies its impact on predictability, and the Throughput Histogram measures its effect on total output.

Decoding the Data: From Charts to Actionable Insights

A dashboard full of charts is only as valuable as the insights it helps generate. The next step is to move from observing patterns to performing a diagnostic analysis to understand their root causes. This process involves using the data to ask targeted questions about the workflow and identify specific areas for improvement.

Identifying Bottlenecks: The Primary Diagnostic Goal

A bottleneck is any stage in the workflow where the demand for work exceeds the capacity to process it, causing tasks to queue up and wait. Identifying and managing bottlenecks is the single most effective way to improve the overall flow of work. The dashboard provides multiple ways to detect them:

  • Visual Clues on the Board: The simplest method is direct observation. A column on the Kanban board where cards consistently pile up is a bottleneck.

  • Cumulative Flow Diagram Evidence: As discussed, the definitive sign of a bottleneck on a CFD is a widening band corresponding to a specific workflow stage. The stage whose band is expanding is the constraint in the system.

  • Work In Progress (WIP) Limits as a Trigger: A well-configured Kanban system uses WIP limits on each "In Progress" column. A column that is constantly at or over its WIP limit is, by definition, the bottleneck. The limit acts as an automatic alert system.

  • Cycle Time Analysis: By breaking down the total cycle time into the time spent in each column, one can identify which stage contributes the most to the overall duration. The stage where tasks spend the most time is often the bottleneck.

Once a bottleneck is identified, it is crucial to recognize it not as a personal failing but as a systemic issue. A common reaction to seeing tasks pile up in a "Review" stage might be to assume the reviewer is slow. However, the data encourages a more holistic analysis. The problem could stem from upstream issues, such as low-quality work arriving at the review stage that requires significant rework. It could be a capacity issue, where one person is the only one with the skills to perform that step, creating a single point of failure. Or it could be a policy issue, where the WIP limits on preceding stages are too high, flooding the bottleneck with more work than it can handle. By focusing on the data, the inquiry shifts from "Why is this person underperforming?" to "Why is work getting stuck at this point in the system?". This depersonalizes the problem and opens the door to more constructive, process-oriented solutions.

Gauging Stability and Predictability

A stable process is a predictable one. Predictability is essential for effective planning and for building trust with stakeholders (or for simply trusting one's own commitments). The dashboard provides clear indicators of process stability:

  • The Control Chart: This is the primary tool for assessing predictability. The spread of the cycle time dots is a direct measure of variability. A narrow standard deviation band indicates that the time it takes to complete tasks is consistent and therefore predictable. Commitments based on the average cycle time can be made with high confidence. A wide spread indicates an erratic process where commitments are essentially guesses.

  • The Throughput Histogram: This chart assesses the consistency of output. A predictable system will have a narrow, tightly clustered histogram, showing that a similar amount of work gets done each day or week. An unpredictable system will have a wide, flat distribution, indicating that output varies wildly.

Understanding Work Item Aging: A Leading Indicator

While most metrics like Cycle Time and Throughput are lagging indicators—they can only be measured after work is complete—there is a powerful leading indicator called Work Item Age. Work Item Age is the amount of time a task has been in progress so far.

By monitoring the age of items currently in the "Doing" columns, one can proactively identify tasks that are at risk of becoming outliers. For example, if the Control Chart shows that 85% of tasks are completed within 10 days, any item currently in progress that is already 9 days old is a risk. This allows for early intervention. Instead of waiting for the task to become a negative data point on the Control Chart, one can investigate immediately: "Why is this task taking so long? Is it blocked? Does it need to be broken down further?" This proactive management of aging work is a key practice for maintaining a healthy and predictable flow.

Advanced Forecasting: Probabilistic Planning for Personal Goals

Perhaps the most powerful application of a data-driven productivity dashboard is its ability to transform planning and estimation from a subjective art into a data-driven science. Traditional methods of estimation, often based on "gut feel" or detailed but speculative task breakdowns, are notoriously unreliable in the context of knowledge work, which is inherently variable and complex. Probabilistic forecasting offers a robust alternative that embraces this uncertainty.

The Shift from Deterministic to Probabilistic Thinking

The fundamental flaw in traditional estimation is the pursuit of a single-point, deterministic answer to the question, "When will this be done?" This approach ignores the statistical reality of variation in workflows. A probabilistic approach reframes the question to: "Given my past performance, what is the probability of this being done by a certain date?". This shift from seeking certainty to quantifying uncertainty is the cornerstone of modern agile forecasting. It allows for conversations about risk and confidence levels rather than promises that are easily broken.

Monte Carlo Simulations: Simulating the Future Based on the Past

The primary tool for probabilistic forecasting in a Kanban system is the Monte Carlo simulation. The method is a computational technique that runs thousands, or even millions, of random simulations of a future event based on a model of historical data.

For personal productivity forecasting, the methodology is as follows :

  1. Gather Historical Data: The only input required is a history of daily or weekly throughput, which is taken directly from the data used to generate the Throughput Histogram.

  2. Run a Simulation: To simulate one possible future, the algorithm randomly samples from the historical throughput data for each future day or week in the forecast period. For example, to simulate a future week, it might randomly pick the throughput value from a Tuesday three weeks ago, a Friday one week ago, a Monday from last month, and so on.

  3. Repeat Thousands of Times: This simulation is repeated thousands of times, generating a vast set of possible future outcomes.

  4. Analyze the Distribution: The results of these thousands of simulations are plotted on a histogram, which shows the range of possible outcomes and the frequency with which each occurred.

A key strength of this method is that the historical throughput data inherently includes all the real-world variability and interruptions—meetings, sick days, urgent requests, creative blocks, and vacations. The simulation doesn't need to guess at these factors; it assumes a future that will be statistically similar to the past, with a similar level of disruption.

Answering the Two Key Questions

Monte Carlo simulations are used to answer two fundamental planning questions :

  1. "How Many?" (Fixed Date, Variable Scope): This simulation answers the question, "Given a fixed deadline, how many tasks can I likely complete?" For example, "How many articles can I write by the end of the quarter?" The output is a probability distribution showing the likelihood of completing a certain number of items. A typical result might be: "There is an 85% probability of completing 12 or more articles, and a 50% probability of completing 15 or more."

  2. "When?" (Fixed Scope, Variable Date): This simulation answers, "Given a fixed set of tasks, when am I likely to finish?" For example, "I have a project with 20 remaining tasks. When will it be done?" The output is a probability distribution of completion dates. A typical result might be: "There is an 85% probability this project will be finished on or before November 19th, and a 95% probability it will be finished by December 6th.".

This approach fundamentally changes the nature of making commitments. A traditional commitment is a deterministic statement ("This will be done by Friday"), which is fragile and often leads to stress. A probabilistic forecast transforms the commitment into an exercise in risk management ("There is an 85% chance this will be done by Friday"). This allows for a more mature and realistic conversation about deadlines. One can choose a delivery date based on an acceptable level of risk—a more aggressive date with lower confidence, or a more conservative date with higher confidence. This replaces anxiety-driven guesswork with a data-driven assessment of probabilities, empowering the individual to make commitments they can trust.

The Personal Productivity Flywheel: Applying Insights to Your Daily Routine

The ultimate goal of the personal productivity dashboard is not merely to generate interesting charts but to create a virtuous cycle of continuous improvement—a "flywheel" where data leads to insights, insights lead to small changes, and those changes generate new data, driving the cycle forward. This section provides a practical framework for applying the dashboard's insights to one's daily and weekly routines.

Setting and Tuning Your Personal WIP Limits

The most powerful lever an individual can pull to influence their workflow is the Work In Progress (WIP) limit. Its purpose is to enforce focus and create a smooth, predictable flow by compelling the completion of existing work before starting new tasks. The cognitive cost of multitasking is well-documented; each context switch incurs a time penalty as the brain re-engages with a different problem, leading to massive inefficiencies when juggling multiple active tasks.

Practical Guidance:

  • Start Small: For an individual, a WIP limit of two or three for the primary "Doing" column is a good starting point. The goal is to set a limit that feels slightly constraining.

  • Use the Data to Tune: The dashboard provides the feedback needed to adjust the WIP limit. If the data shows significant idle time (team members running out of work, a low-WIP scenario), the limit may be too low. Conversely, if the Control Chart shows rising and erratic cycle times and the CFD shows widening bands, the WIP limit is likely too high, allowing too much work to enter the system and create congestion.

  • Embrace the "Beneficial Pain": An effective WIP limit will inevitably create moments of "blockage." For example, if the WIP limit is two and both active tasks are blocked (e.g., waiting for external feedback), the system prevents the individual from pulling in a third task to "stay busy." This is not a flaw; it is the system's core feature. This forced idleness is a powerful signal that the blockers must be resolved to restore flow. Without a WIP limit, the tendency is to start a third task, allowing the first two to age and clog the system. The WIP limit makes systemic problems impossible to ignore, thereby forcing their resolution.

The Art of Right-Sizing Your Tasks

The stability of a workflow is heavily influenced by the size and variability of the work items flowing through it. A process that contains a mix of one-hour tasks and three-week projects will naturally have a chaotic and unpredictable cycle time, rendering the Control Chart almost useless.

A key practice for improving predictability is to break down large initiatives into smaller, more uniformly sized tasks. This does not mean every task must take exactly the same amount of time, but it does mean avoiding massive variations in effort. A well-sized task is typically something that can be completed in a few hours or a few days. This practice has two major benefits:

  1. Improves Flow: Smaller tasks move across the board more quickly, providing a more continuous sense of progress and preventing large items from stagnating and blocking the system.

  2. Improves Data Quality: A stream of more uniformly sized tasks generates more consistent cycle time and throughput data, which in turn makes the Control Chart more stable and the Monte Carlo forecasts far more reliable.

Implementing a Personal Feedback Loop (The "Personal Retrospective")

Kanban is a method of continuous, evolutionary improvement. This improvement is driven by regular feedback loops. For an individual, this can be implemented as a "personal retrospective"—a scheduled weekly or bi-weekly review of the productivity dashboard. During this review, one should ask specific, data-guided questions:

  • Control Chart Review: "Which tasks were the highest and lowest outliers on my Control Chart this week? What was the story behind them? What can I learn from the task that was completed exceptionally fast? What caused the delay in the one that took three times the average?".

  • CFD Review: "Did any of my workflow stages show a widening band? Where did work pile up? Was I waiting for something? Is there a systemic delay I need to address?".

  • Throughput Histogram Review: "How did my throughput this week compare to my historical distribution? Was it a high-output week or a low-output week? What factors contributed to that outcome?".

  • Aging WIP Review: "Do I have any tasks that have been in progress for an unusually long time? What is blocking them? What action can I take today to get them moving again?"

This structured, data-informed reflection is the engine that powers the productivity flywheel. It ensures that improvements are not random but are targeted at the specific constraints and sources of variability revealed by the individual's own work data.

Building Your Dashboard: A Review of Modern Kanban Tools

The principles and metrics discussed are universal, but their implementation is facilitated by software. A variety of project management tools offer Kanban boards, but they differ significantly in their native analytics and reporting capabilities. The choice of tool should be guided by an individual's technical comfort, budget, and the desired depth of analysis.

Comparative Analysis of Popular Platforms

  • Kanbanian.com: Positioned as a "Kanban OS," Kanbanian.com is a highly flexible and visually-driven platform that can be adapted to a wide range of workflows, including Kanban. Its primary strength in analytics lies in its highly customizable dashboards. Users can build dashboards that pull data from multiple boards and use a variety of "widgets"—such as charts, numbers, and progress batteries—to visualize metrics. While this offers immense flexibility for general reporting, creating the specific flow metric charts like a true CFD or Control Chart may require more manual configuration within the chart widget than in a specialized tool like Jira. It is an excellent choice for users who want a single, all-in-one platform for work and reporting and value high-level, customizable visual summaries.

  • Jira: Developed by Atlassian, Jira is a powerful and highly configurable project management tool widely used in software development. Its strength for building a productivity dashboard lies in its robust, native support for Agile metrics. Jira includes built-in reports for both Cumulative Flow Diagrams and Control Charts, providing deep analytical capabilities out of the box. This makes it an excellent choice for data-intensive users who want a comprehensive suite of flow metrics without relying on third-party integrations. The platform's dashboards are also highly customizable with a wide array of "gadgets" for displaying reports and data.

  • Trello: Also an Atlassian product, Trello is known for its simplicity, visual appeal, and ease of use. Its core strength is its straightforward and intuitive Kanban board interface. However, Trello's native reporting capabilities are very basic, limited to simple card counts per list, member, or label for premium users. The true power of Trello for analytics is unlocked through its extensive ecosystem of third-party integrations, known as "Power-Ups". Tools like Screenful, Corrello, and Nave integrate with Trello to provide the sophisticated charts discussed in this report, including CFDs, Control Charts, Throughput Histograms, and Monte Carlo simulations. This makes Trello a highly flexible option for users who prioritize simplicity in their daily interface but are willing to add specialized tools for deeper analysis.

The Role of External Business Intelligence (BI) Tools

For ultimate analytical power and customization, data from any of these Kanban platforms can be exported (typically via CSV files or an API) and loaded into a dedicated Business Intelligence (BI) tool like Tableau, Power BI, or Google Sheets. This approach requires more technical setup but offers limitless possibilities for creating bespoke dashboards, blending Kanban data with other data sources, and performing advanced statistical analysis beyond the scope of the native tools.

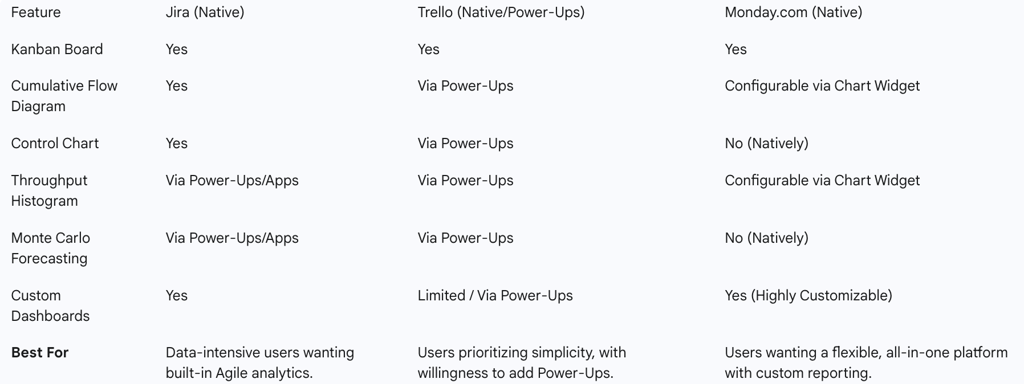

The following feature matrix provides an at-a-glance comparison to aid in tool selection.

 feature matrix provides an at-a-glance comparison to aid in tool selection
 feature matrix provides an at-a-glance comparison to aid in tool selection

Conclusion: Embracing an Evolutionary Approach to Personal Effectiveness

This report has detailed a comprehensive framework for transforming personal productivity from a reactive, task-based activity into a proactive, data-driven system. The journey from a simple to-do list to a sophisticated personal productivity dashboard represents a fundamental paradigm shift. The individual is no longer merely a "doer" of tasks but becomes the manager, analyst, and optimizer of their own unique workflow system. This approach moves beyond generic advice and provides a personalized, evidence-based path to greater effectiveness.

The core principles that enable this transformation are simple in concept but profound in application: visualize your work, limit your work in progress, and measure the flow. By visualizing work on a Kanban board, the invisible processes of knowledge work become tangible and measurable. By limiting WIP, one actively combats the inefficiencies of multitasking and creates the focus necessary for a smooth and predictable workflow. And by measuring the flow through key metrics and visualizations, one generates the objective feedback necessary for intelligent improvement.

The ultimate goal of this system is not to achieve a state of static perfection. Workflows are dynamic, priorities shift, and life introduces variability. The true power of the personal productivity dashboard lies in its ability to provide the navigational tools needed to adapt and evolve. It is not a final destination but a compass and a map, guiding a journey of continuous, incremental improvement. This aligns perfectly with the foundational Kanban principle of pursuing improvement through evolutionary change. By embracing this analytical and evolutionary mindset, an individual can move beyond the chronic stress of feeling overwhelmed and uncertain. They can gain a deep, data-backed understanding of their own capacity, predictability, and process, fostering a sense of control and sustainable effectiveness that is essential for thriving in the complex world of modern knowledge work.
